Data Center Site Selection Criteria and Considerations Picking a data center location is not a real estate decision. It's an uptime, latency, compliance, and cost decision that happens to involve a building.

Many organizations still choose a site based on rent, proximity to headquarters, or available square footage. That approach skips the factors that actually determine whether the facility works: power capacity, network diversity, cooling resources, hazard exposure, and permitting timelines.

Get those wrong, and you're looking at outages, blocked expansion, or a multi-year permitting fight you didn't see coming.

This guide walks through a practical framework: define your requirements, assess infrastructure, investigate geographic and regulatory risk, then compare finalists using a weighted scorecard and total cost of ownership (TCO).

Key Takeaways

  • Power, cooling, and network diversity are nonnegotiable foundations—screen these before anything else.
  • Natural hazards, zoning, water access, and permitting can kill an otherwise perfect site.
  • Separate nonnegotiable requirements from preferences, then score every candidate against the same evidence.
  • Total cost of ownership, not headline lease price, should drive the final call.
  • Liquid cooling, edge sites, and distributed storage now belong in site requirements for 2025 and beyond.

Start With Business and Technical Requirements

Before you tour a single site, define what the facility actually needs to support:

  • Workloads and applications
  • Users and availability targets
  • Compliance obligations
  • Launch date

Skip this step, and you'll be retrofitting a site that never fit in the first place.

Translate those needs into measurable requirements:

  • Rack count and power allocation
  • Floor space and floor loading
  • Network capacity and cooling method
  • Delivery timeline

Establish Current and Future Capacity Requirements

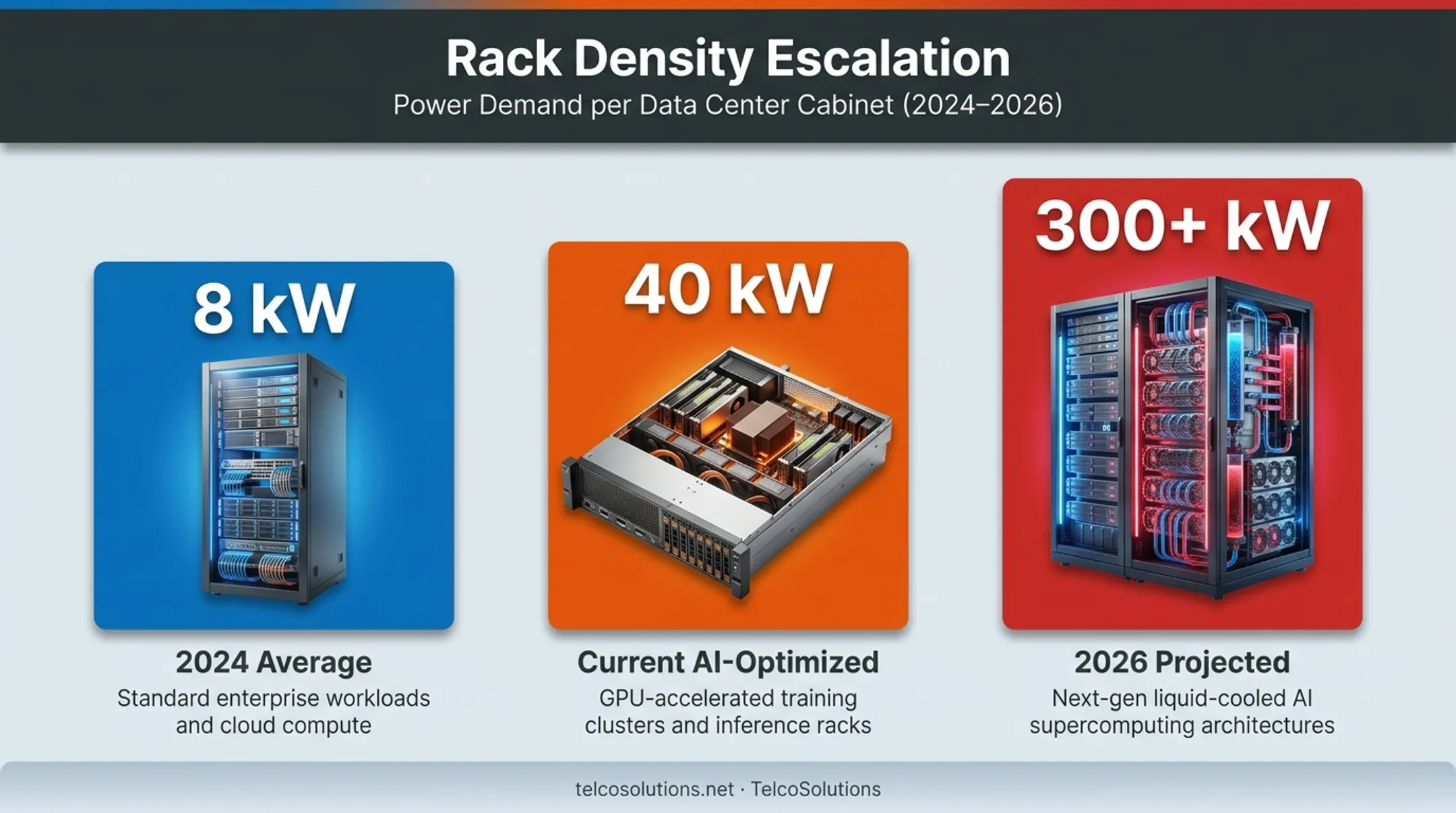

Rack density is climbing fast. Uptime Institute's 2024 survey found average rack density around 8 kW, but current AI-optimized racks already run near 40 kW, with some rack-scale systems projected to hit 300 kW or more by 2026.

Rack power density growth from 8kW average to 300kW AI systems

If your site can't accommodate that trajectory, you'll be relocating within a few years.

Document today's IT load, then forecast growth across:

  • Servers, storage, and network equipment
  • Cloud connectivity requirements
  • High-density or AI-specific workloads

Confirm the real usable footprint, not just total building size:

  • Rack dimensions and ceiling height
  • Floor loading capacity
  • Staging areas, loading docks, and equipment-movement routes

Require a documented expansion path covering additional cabinets, power blocks, cooling capacity, and network ports. It should not require a disruptive relocation to execute.

Set Resilience and Service-Level Objectives

Define your acceptable availability, maintenance windows, and recovery objectives. Then map those numbers to actual redundancy: utility feeds, UPS systems, generators, cooling equipment, and network paths.

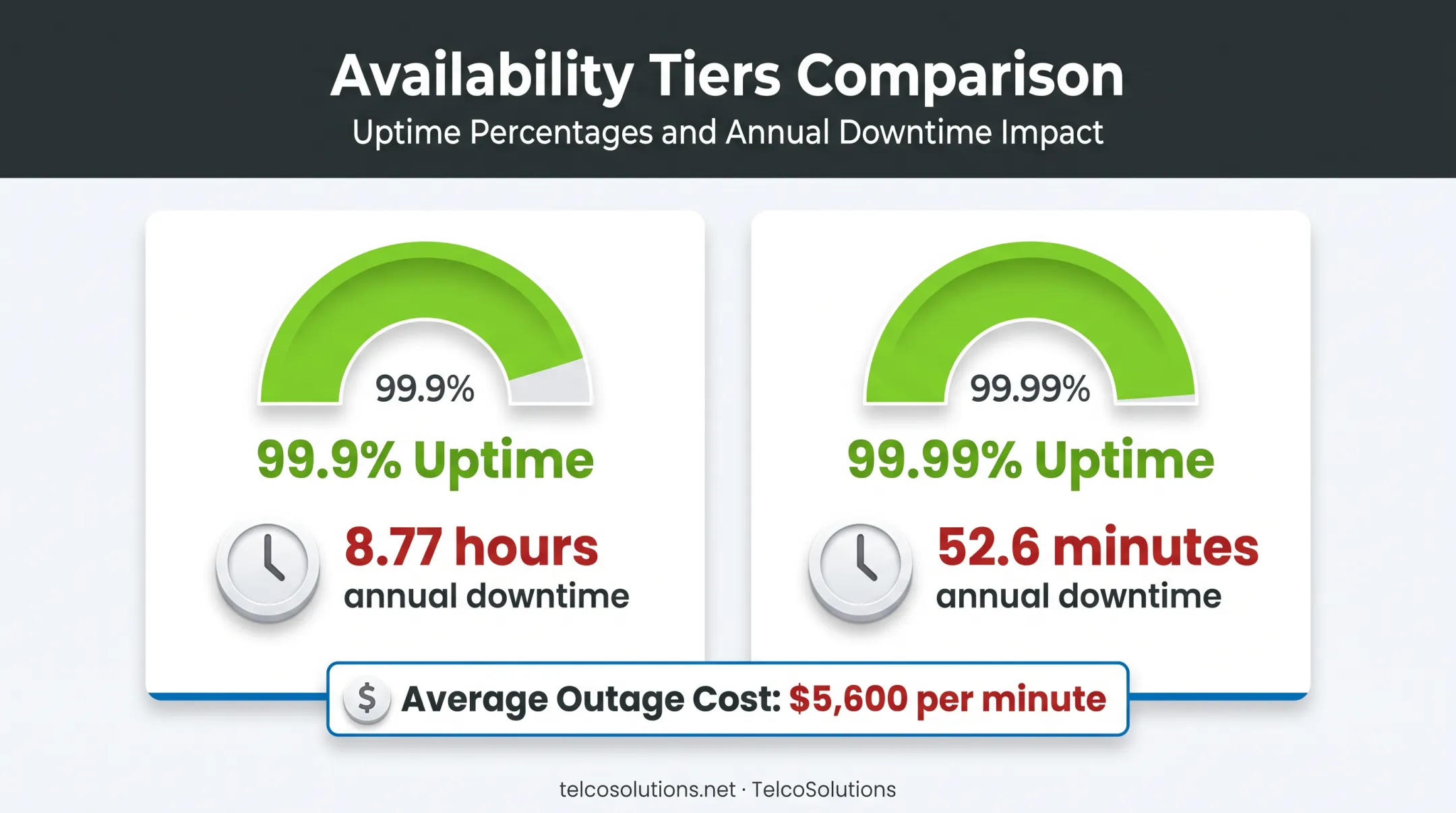

Gartner estimates the average cost of a network outage at $5,600 per minute, or more than $336,000 per hour. A 99.9% uptime SLA still allows 8.77 hours of downtime annually; 99.99% cuts that to 52.6 minutes.

Uptime SLA percentages compared to allowed annual downtime minutes

Identify single points of failure before you sign anything. Ask for evidence showing how the facility handles planned maintenance, equipment failure, and utility disruption, not just marketing claims.

Align the Site With Workload Location Needs

Is your priority low latency to end users? Proximity to cloud regions? Disaster recovery separation from a primary site? Data sovereignty for regulated data? Each priority points to a different geography. Rank them before you start touring so location tradeoffs stay intentional.

Evaluate Infrastructure, Connectivity, and Physical Facility Readiness

Power, cooling, connectivity, and physical design are interdependent. A site with generous floor space is worthless if it can't deliver reliable power or connect to diverse carriers.

Assess Utility Power and Backup Capacity

Utility deliverability is a bigger risk than most site-selection teams realize. LBNL counted nearly 11,600 active U.S. interconnection projects at the end of 2023. Only about 20% of projects seeking interconnection between 2000 and 2018 actually reached operation, and a typical project built in 2023 took nearly five years from request to energization. Before committing, verify:

  • Current utility capacity and substation proximity
  • Delivery timelines and future expansion commitments
  • Outage history and utility rates
  • Independent utility feeds, UPS topology, and generator runtime
  • Fuel storage capacity and testing records Tier III and IV facilities are built around this redundancy, combining UPS backups, diesel generators, and disaster-recovery failovers to sustain 99.99%+ uptime.

Evaluate Cooling, Water, and Equipment Density

Match cooling design to your actual rack density. Air cooling won't cut it for high-density AI workloads. Uptime's 2024 Cooling Systems Survey found 22% of respondents already use some direct liquid cooling (DLC), and 61% don't use it yet but are considering it. Data Center Frontier's 2025 trend reporting treats liquid cooling as a standard requirement for high-density deployments, not an edge case. Verify:

  • Cooling redundancy and temperature/humidity controls
  • Water source, usage, and water-stress exposure
  • Facility documentation, not regional climate assumptions

Verify Connectivity and Carrier Diversity

Many "redundant" designs still fail in practice. Confirm access to multiple ISPs, cloud on-ramps, and diverse fiber routes that enter through physically separate pathways. Dedicated fiber remains the backbone: symmetrical speeds and strong baseline reliability. Fiber alone can still be a single point of failure, so plan a second physical path (such as fixed wireless or cellular) and automatic failover across links. Confirm:

  • Building-, campus-, and metro-level redundancy
  • Whether "independent" circuits actually share conduits or rights of way
  • Cross-connect availability and carrier-addition timelines TelcoSolutions works with organizations on this layer directly, sourcing connectivity across a network of 300+ carriers to build a diverse, failover-ready mix instead of relying on a single provider's claims.

Inspect Facility Design, Security, and Operations

Physical security and network security now go hand in hand. Look for 24/7 surveillance, biometric access control, multi-factor authentication, and real-time threat detection, not just a guard desk and a camera. Request evidence, not assurances:

  • Commissioning and maintenance records
  • Testing schedules and incident history
  • Compliance reports matched against on-site conditions

Assess Geographic, Environmental, Regulatory, and Community Risks

A technically excellent facility can still be a bad choice if its location carries hazard exposure, water constraints, or a permitting fight waiting to happen.

Investigate Natural Hazards and Climate Exposure

Layer multiple official data sources before engineering diligence begins:

Hazard Type Source
Flooding FEMA Flood Map Service Center
Seismic risk USGS National Seismic Hazard Model
Storm surge NOAA National Storm Surge Risk Maps
Drought U.S. Drought Monitor
Wildfire USFS Wildfire Hazard Potential

Each hazard affects more than the building itself. It can disrupt power, fiber, fuel delivery, staffing, and recovery time simultaneously.

Review Zoning, Permitting, and Compliance Obligations

Permitting delays and community pushback are increasingly common. In 2025 alone, projects in Tarboro, North Carolina and College Station, Texas were rejected over noise, water, and utility concerns, per Data Center Frontier's community-watch reporting.

Confirm land-use permissions, building and electrical codes, emissions requirements, and generator/fuel regulations for the specific jurisdiction. Every locality treats these differently.

Local approvals are only half the picture. Industry data rules also dictate where certain workloads can live:

  • Healthcare: HIPAA-compliant environments for EMRs and patient records
  • Finance & insurance: Encrypted storage for sensitive transaction data
  • Legal & government: Secure document storage with access logs and retention compliance
  • International customer data: May fall under GDPR or other data-sovereignty rules

Many organizations now spread storage across regions to satisfy multiple international data laws at once.

Evaluate Sustainability and Community Conditions

Compare the region's energy mix, renewable procurement options, and water availability. Then look at the human side: workforce availability, emergency services access, and the jurisdiction's track record with major infrastructure projects.

Early engagement with utilities and nearby residents, before construction starts, surfaces concerns about noise, traffic, and water use before they become project-killing delays.

Compare Finalists Through Due Diligence and Total Cost of Ownership

Build a Weighted Site-Selection Scorecard

Rank non-negotiable requirements first. Then assign consistent weights to performance, resilience, connectivity, security, compliance, sustainability, and cost.

Every score needs backing evidence:

  • Utility letters and engineering documents
  • Carrier maps and service-level agreements
  • Hazard assessments and site-visit observations

Validate Commercial Terms and Long-Term Costs

TCO analysis should cover the full lifecycle, including acquisition, implementation, energy use, maintenance, and eventual disposal—not the lease alone. Gartner’s TCO methodology and Forrester’s Total Economic Impact framework are useful structures for that breakdown.

Build three scenarios, not one:

  1. Best case: everything performs as promised
  2. Worst case: outages, delays, or cost overruns hit
  3. Most likely: a realistic blend of both

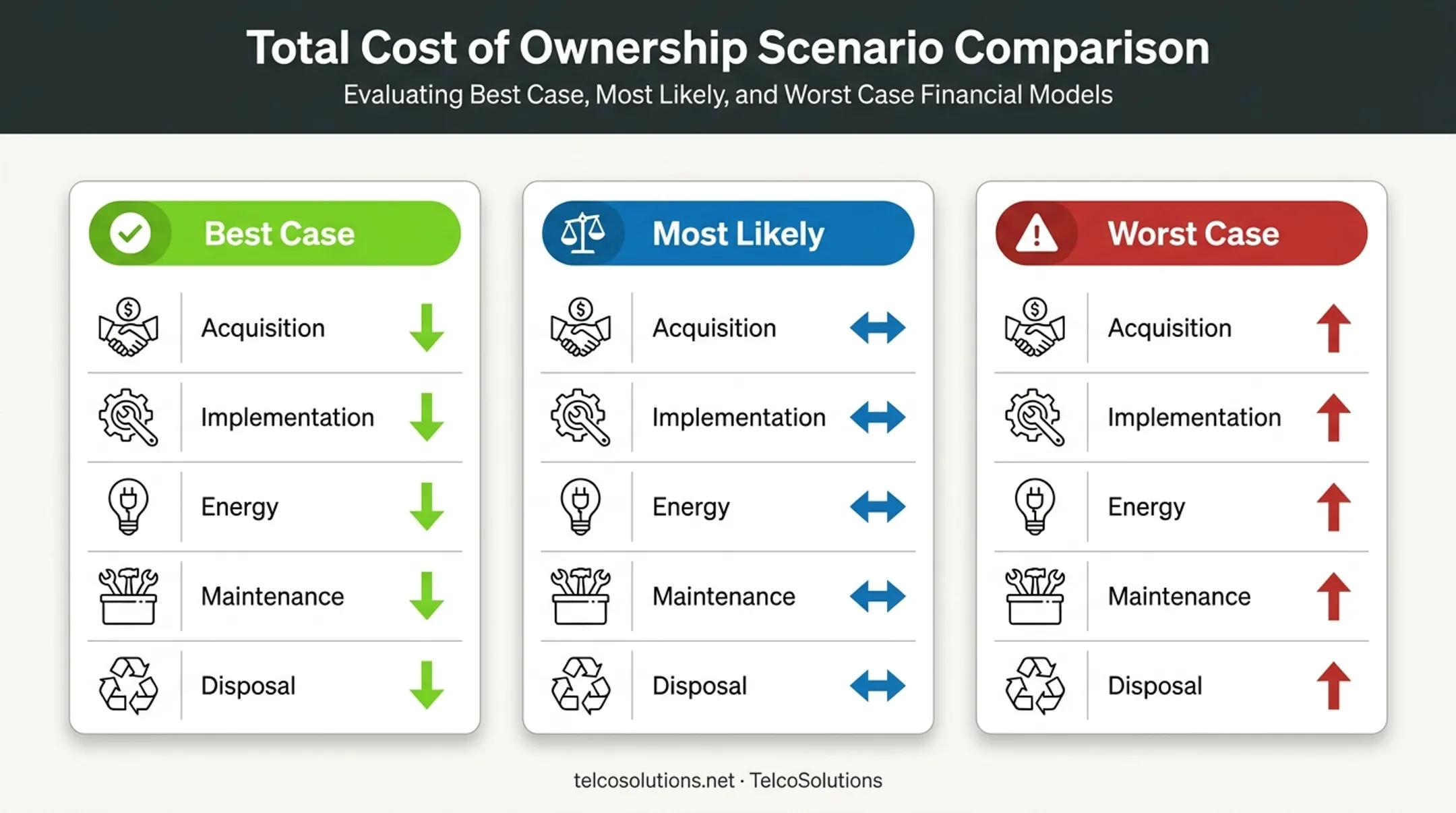

Best case worst case and most likely TCO scenario comparison chart

Include qualitative factors too. Vendor support quality, ease of scaling, and responsiveness deserve their own weighted scores alongside the hard numbers.

For organizations weighing colocation versus a dedicated site, TelcoSolutions can help evaluate connectivity and colocation needs together, with recommendations tailored to existing systems and operational priorities.

Complete Site Visits and Final Verification

Don't sign based on a data sheet. Walk the facility. Check fiber entrances, backup systems, loading logistics, and cooling infrastructure in person.

Reconcile what you find against the questionnaire answers and contract promises. Document any gaps, assign owners, and pick the site that scores best against your weighted requirements rather than the lowest headline price.

Frequently Asked Questions

What are the requirements for a data center?

A data center needs reliable, redundant power; adequate cooling; diverse network connectivity; sufficient physical space; and strong security and monitoring. It also needs compliance coverage, disaster resilience, staffing, and room for future expansion.

How do I choose a data center location?

Balance workload location needs, latency, power availability, connectivity, hazard exposure, regulatory requirements, sustainability, and cost. No single factor should override the others. Weigh each one against your specific business priorities.

Why is power availability important in data center site selection?

Utility capacity, redundancy, and backup generation directly determine uptime. Interconnection queues can take years to clear, so power deliverability should be verified early, not assumed.

What environmental risks should be considered when selecting a data center site?

Flooding, severe storms, wildfire, seismic activity, extreme heat, and drought all threaten uptime and recovery time. Water availability also affects long-term cooling capacity and operating costs.

How does connectivity affect data center site selection?

Latency, carrier diversity, and physically separate fiber routes determine both performance and resilience. Shared conduits or rights of way can create hidden single points of failure even when routes look independent on paper.

What makes a data center site scalable?

Available floor space, expandable power and cooling capacity, and modular construction all support growth. Diverse connectivity options and contract rights for future expansion round out a scalable site.
